Short answer: AI can build and check the budget, but it cannot price it. Source-verified workflow; chatbot features checked October 2026, no hands-on cost test.

Can AI Estimate Your Renovation Cost? A ChatGPT Budget Workflow

Ask a chatbot what your bathroom remodel will cost and it will give you a number, often with confidence and sometimes with a source that does not exist. That number is the least useful thing it can do for you. ChatGPT and Gemini are good at turning a vague plan into a list of line items, reminding you of the costs people forget, and doing arithmetic you can check. They do not know what a plumber charges in your town this month. This workflow uses AI for the structure and the maths, and real sources for every price.

Resident working through printed budget sheets and a bathroom plan at a table, with the dated bathroom visible through the open door

Image: Generated for Interior Index. Illustrated budget planning scene, not a real renovation estimate or a tested tool output.

Key points

  • What AI does well: Breaks a scope into line items with quantities, lists forgotten costs such as disposal and permits, and recalculates totals you can check.
  • What it cannot do: Give a current local price. Treat every figure it suggests as a placeholder until you replace it with a dated source or a quote.
  • Contingency: A common guideline is 10 to 20 percent on top of the priced work, towards the top for older homes and work that opens walls or floors.
  • Finish with quotes: Use the line items as a question list for contractors, then compare every quote against the same lines, not against the AI total.

Can AI estimate renovation costs?

Partly. A general chatbot can structure an estimate, but it cannot supply the prices that make an estimate true. OpenAI's own help page on whether ChatGPT tells the truth warns that the model can sound confident when it is wrong, can produce fabricated citations, and only knows recent information when a search tool is used. Local labour rates and this month's material prices are exactly that kind of information. The table sorts the budgeting jobs by how far you can rely on the answer.

JobHow the chatbot does itHow far to trust it
Break a scope into line itemsReads your notes and lists the work, materials and labourHigh as a draft; you add what it missed
Remind you of forgotten costsLists disposal, permits, delivery, patching, cleanupHigh; it is a checklist, not a price
Calculate quantities from measurementsFloor area, wall area, waste allowanceMedium; check the formula and your inputs
Add up the budgetArithmetic, or code in a data-analysis toolMedium; keep the master copy in a spreadsheet
Say what an item costs where you liveA figure from training data or a web searchLow: replace it with a dated source or a quote
Predict what is behind the wallsIt will guessNone: only opening up or an inspection shows it

The five-step budget workflow

The order matters. Scope comes before prices because a price is only meaningful for a defined piece of work, and quotes come last because they are how you test the whole budget against the market.

You AI drafts You source Guideline Contractors Step 1: scope and measurements, written by you Step 2: line items with quantities, drafted by AI Step 3: sourced prices, found by you Step 4: contingency, from a published guideline Step 5: contractor quotes compared line by line Scope Line items Sourced prices Contingency Quotes When quotes arrive, update the same line items Only the shaded step is AI work; the others need real sources
The chatbot drafts one step. Prices, the contingency and the quotes all come from outside the chat.

Step 1: Write the scope and measurements

A chatbot can only list the work you describe. Before you open it, write down five things: the room's floor dimensions and ceiling height, what is being removed, what is being installed, what stays, and the age of the house. Measure with a tape, not from a listing or a floor plan app's estimate; our guide to measuring a room correctly covers what to record.

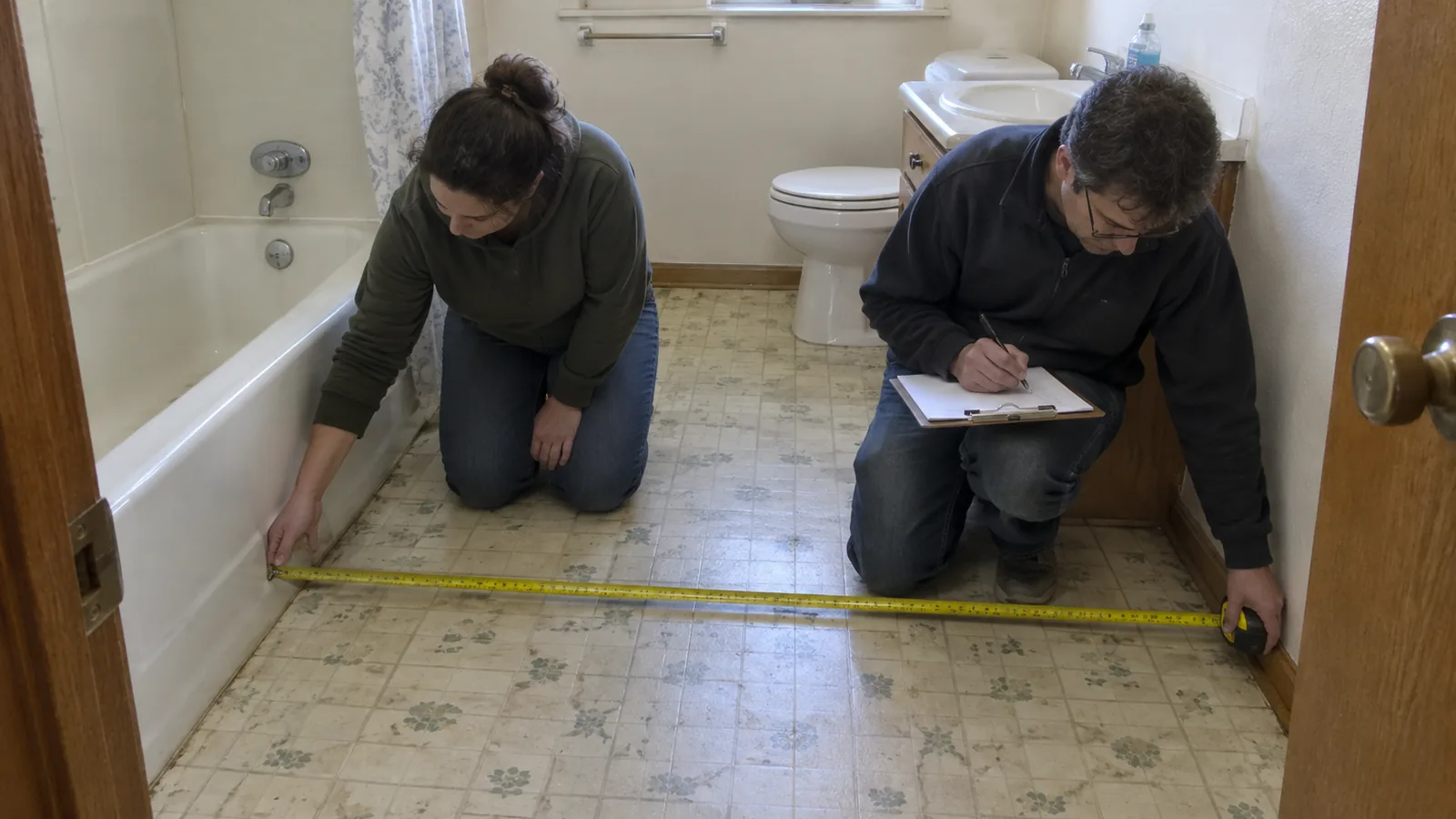

Two people measuring the open floor of a dated bathroom from the tub apron to the opposite wall, one recording it on a clipboard
Record defined spans and the surfaces they run between before drafting the scope. Confirm the actual numbers with your own measurements.

Then ask the chatbot to find the gaps before it counts anything. The prompt below makes it act as a checker rather than an estimator; answer each question and add the answers to your written scope. The most expensive word in renovation is "while": while the floor is up, while the wall is open. Decide now which of those you are including.

I am planning a renovation of my [room]. It is [length] x [width] ft with a [height] ft ceiling, in a house built around [year]. I want to remove [list], install [list], and keep [list]. Before estimating anything, ask me up to six questions about anything missing from this scope that would change the cost, such as what is under the floor, whether plumbing or wiring moves, who supplies the materials, and who handles disposal. Ask one question at a time. Do not give any prices yet.

Step 2: Ask for line items, not a total

A single total hides every assumption inside it. Ask for a table instead, with each assumption written next to the line it affects, and with prices left blank so you are not anchored by a number you cannot check. These are the columns to ask for:

ColumnWhy it is there
Materials or labourQuotes often split them; keeping them apart lets you compare like with like
Quantity and unitLets you check the maths from your own measurements
Unit priceFilled in by you from a dated source, never by the chatbot
AssumptionShows what has to be true for the line to hold, such as "subfloor reused"
Source and date (add it yourself)Where the price came from and when you checked it

Turn my scope into a line-item budget table with these columns: item, materials or labour, quantity, unit, unit price, line total, assumption. Calculate quantities from my measurements and show each formula. For flooring, add a waste allowance and label it as a rule of thumb. Leave every unit price blank and write "needs price" in it. Then list any costs people often forget for this kind of job that are not yet in the table. Do not cite any source unless you give a link I can open.

The output is a draft structure, and it is usually the most valuable thing in the whole session. Read it line by line. If it assumes the subfloor is sound, or that you will reuse the existing shut-off valves, those are assumptions you now know to ask a contractor about.

Step 3: Replace AI prices with sourced figures

Copy the table into a spreadsheet and fill the price column from three kinds of source, in rising order of trust: published cost guides, retailer prices for the exact products you have chosen, and written quotes. Record the date next to each price. Keep the formulas in the spreadsheet, not in the chat, so a total can never silently change between messages.

Illustration linking three source objects to three separate highlighted cells in a budget spreadsheet
Every price in the sheet should trace back to a cost guide, a retailer listing or a quote, with the date you checked it.

Published datasets are useful for a sanity check, as long as you know what they measure. The 2025 Cost vs Value Report from the Journal of Light Construction compares the average cost of 28 defined remodelling projects with the value they retain at resale, across 119 US markets. Its methodology builds costs from price indices and Verisk remodelling cost data, and estimates resale value from a survey of more than 6,000 Realtors. Its midrange bath remodel is one specific job: a 5 x 7 ft bathroom with every fixture replaced, including the tub, tile surround, toilet, vanity counter, medicine cabinet and tile floor.

Pacific National average East South Central Pacific: $27,710 National average: $26,138 East South Central: $23,409 $27,710 $26,138 $23,409 Average job cost, midrange bath remodel, 2025 Bars start at $0; scale $1,000 = 9 units
The same defined 5 x 7 ft bathroom job costs about $4,300 more in the Pacific region than in East South Central. A national figure is not your price. Source: 2025 Cost vs Value Report, national and regional pages, checked October 2026.

The report's own note on what the numbers mean says small differences in size, scope or finish quality "can dramatically affect the price". Use a figure like this to check that your total is in a plausible range for the scope, not to fill in your line items. If your job is smaller than the defined one, as most refreshes are, expect your total to be well below it.

Step 4: Add a contingency

A contingency is money set aside for work nobody can price until it is found, such as rot under a toilet or wiring that is not to code. It is not a fund for upgrades. Treat the percentages below as a guideline, not a rule: HUD's older 203(k) rehabilitation handbook required cost estimates for houses more than 30 years old to carry a reserve of at least 10 percent of the rehabilitation cost, and no more than 20 percent where major remodelling was planned. A Houzz article by Jeffrey Veffer (August 2025) recommends setting aside 20 percent for unknowns.

  • Cosmetic work only: paint, a fixture swap, nothing opened upTowards 10 percent of the priced work.
  • Floors or walls come up, plumbing or wiring is touchedAround 15 percent, and ask each contractor how they price what they find.
  • Older house, water damage likely, or a layout changeTowards 20 percent, and consider an inspection before you set the budget.

Put the contingency on its own line in the spreadsheet so it stays visible. If you have to cut the budget, cut scope, not the contingency.

Step 5: Turn the budget into contractor questions

Your line items are now the best contractor brief you have. Send the same scope to every contractor, ask for an itemised quote, and compare each quote against your lines rather than against each other's totals. A low total that leaves out disposal or the permit is not cheaper. If you need a fuller written brief first, our guide to writing a design brief with AI has a template.

Here is my scope and line-item budget. Write two things. First, a list of questions to ask a contractor before they quote, covering what is included, what is excluded, allowances for materials I have not chosen, who pulls the permit, how they price problems found after demolition, cleanup and disposal, timeline, payment schedule and warranty. Second, a blank quote comparison table with my line items as rows and three columns for Contractor A, B and C, plus rows for exclusions and allowances. Do not fill in any prices.

Illustration of a scope list beside three contractor quotes with matching rows, where one quote has an empty row highlighted as a missing line
Compare every quote against the same scope, row by row. A quote that leaves out a line, such as disposal or the permit, only looks cheaper.

When you get an allowance in a quote, such as a fixed sum for tile you have not picked, check it against the retailer price you sourced in step 3. An allowance well below the product you want becomes an extra later.

Worked example: a small bathroom refresh

This example shows the method, not the market. Every price below is an example input chosen to make the arithmetic easy to follow. None is a real or current market price. Replace each one with your own sourced figure. The job: a 5 x 8 ft bathroom keeps its tub and tiled surround, and gets a new 30 in vanity, faucet, toilet, mirror and light, a new floor, and paint. For the vanity size and the clearances around it, see our bathroom vanity size guide.

Line itemQuantity and formulaExample inputGroup
30 in vanity with top1$650A Fixtures
Faucet1$150A Fixtures
Toilet1$300A Fixtures
Mirror and vanity light1 each$250A Fixtures
Floor material40 sq ft + 10% waste (rule of thumb) = 44 sq ft x $4.00$176B Materials
Underlayment, adhesive, grout1 lot$80B Materials
Paint and supplies1 lot$120B Materials
Plumbing labour: vanity, faucet, toilet1 job$900C Labour
Flooring labour: remove and install40 sq ft$800C Labour
Electrical labour: light swap1 job$250C Labour
Permit allowance (confirm locally)1$150D Permit and disposal
Disposal and haul-away1$200D Permit and disposal
Subtotal$4,026
Contingency15% x $4,026 = $603.90$604E Contingency
Budget$4,630
Example budget: $4,630 A Fixtures: $1,350, 29% B Floor and paint materials: $376, 8% C Labour: $1,950, 42% D Permit and disposal: $350, 8% E Contingency: $604, 13% A B C D E 29% 8% 42% 8% 13% Example inputs only, not market prices
  • AFixtures: vanity, faucet, toilet, mirror and light, $1,350.
  • BFloor and paint materials, including the waste allowance, $376.
  • CLabour: plumbing, flooring and electrical, $1,950.
  • DPermit allowance and disposal, $350.
  • EContingency at 15 percent of the subtotal, $604.
In this example labour is the biggest share, and labour is the part a chatbot knows least about locally. Get labour prices from quotes first.

Two things in this example are worth copying. The floor line shows its formula, so you can check it when the contractor measures 42 sq ft, not 40. And the permit is an allowance marked "confirm locally", because whether a permit is needed and what it costs is set by your building department, not by a chatbot. The total also sits far below the $26,138 national Cost vs Value midrange bath. That is expected rather than a discount: the example keeps the tub and surround and uses example inputs, so the two are not comparable line by line. A smaller scope should land well below the defined job.

Where AI cost numbers go wrong

None of these failures is rare, and each has a simple fix that keeps the chatbot in the job it does well.

FailureWhy it happensFix
Stale pricesModels are trained up to a cutoff and do not know later prices unless a search tool is usedReplace every figure with a dated source; re-check prices older than a few months
National averages used as local pricesPublished averages describe a defined job, not yours, and vary between marketsUse regional data for a sanity check and local quotes for the line items
Regional labour ratesLabour availability and rates differ by area, and labour is often the largest shareAsk at least three local contractors for itemised quotes
Permits left out or guessedRequirements and fees are set by each local building departmentCheck your building department's site and ask who pulls the permit
Hidden conditionsRot, old wiring or a damaged subfloor only show once something is openedCarry a contingency and agree how discoveries are priced before work starts
Arithmetic slipsTotals drift when a chat recalculates from memory between messagesKeep formulas in a spreadsheet; ask the chatbot to recheck it, not to own it
Invented sourcesOpenAI lists fabricated citations among known hallucinationsOpen every link; delete any figure whose source you cannot read yourself

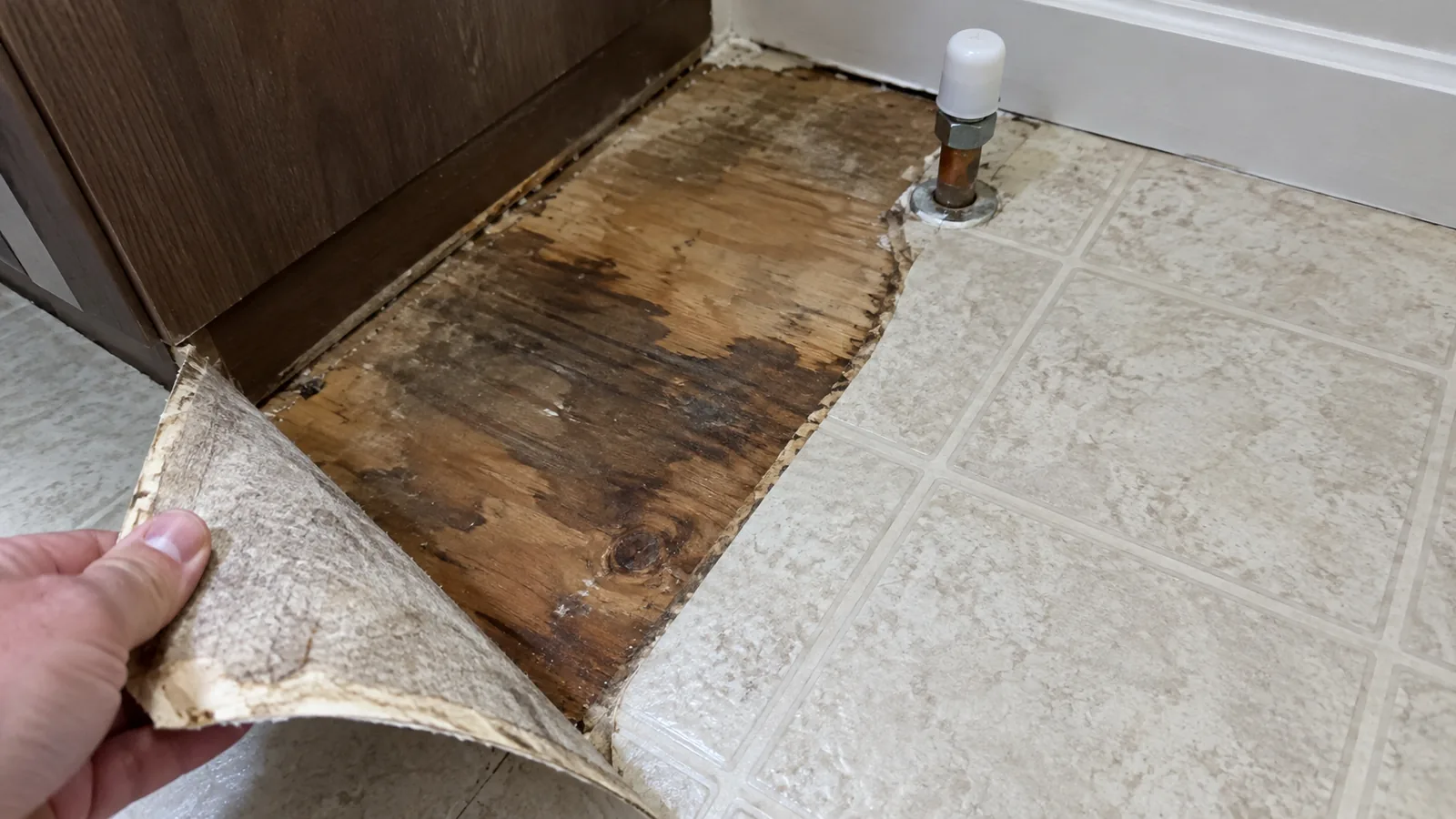

Hand peeling back sheet vinyl flooring to expose a dark water-stained subfloor beside a plumbing supply valve
Hidden conditions can change the scope after opening up the room. Keep a contingency and have the actual condition assessed; a generated scene cannot price the repair.

To check the maths without handing over control, upload your spreadsheet and ask: "Recalculate every line total and the subtotal from the quantities and unit prices in this file. List any line where my total differs from yours. Do not change any price." ChatGPT's data analysis reads .xlsx and .csv files and can run Python for calculations; OpenAI advises reviewing the generated code and assumptions before relying on the result.

What not to paste into a chatbot

A budget needs measurements and a scope. It does not need your address, your name, or a contractor's signed contract. Google's Gemini Apps privacy notice says human reviewers read some chats and asks users not to enter confidential information they would not want a reviewer to see. OpenAI's data controls let you turn off "Improve the model for everyone" so new chats are not used for training. Before pasting a quote, delete or black out:

  • Your street address and any photo that shows it, such as a house number or a view from the window
  • Names, phone numbers, email addresses and signatures, yours and the contractor's
  • Licence, policy, account and bank details, and any payment terms tied to your identity
  • Anything you have agreed to keep confidential under a contract

What the free ChatGPT and Gemini plans cover

Everything in this workflow is text and arithmetic, so the free plans are enough for most budgets. The details below come from each company's own pages, checked in October 2026. Limits change, so confirm them in your account.

NeedChatGPTGemini
Free text chatYes; OpenAI's free tier FAQ describes unlimited everyday text chats, subject to abuse safeguardsYes; $0 a month with a Google Account
Upload a spreadsheet or quoteYes, with separate usage limits on the free tierYes; Google's file upload help covers spreadsheets and documents, with rolling limits that rise on paid plans
Calculations from a fileData analysis runs Python on uploaded filesAsk for a table, then use Export to Sheets and keep the formulas there
Keep the project togetherProjects hold chats, files and instructions for signed-in users, subject to planChats stay in your activity when Keep Activity is on
Paid plans addHigher limits on files, data analysis and toolsHigher usage limits and more models

If you are choosing between the two for wider room planning, our ChatGPT vs Gemini comparison covers where each fits.

What to do next

  1. Measure the room and write the scope: remove, install, keep, and the age of the house.
  2. Run the gap-finding prompt, then the line-item prompt, with prices left blank.
  3. Move the table into a spreadsheet and fill every price from a dated source.
  4. Add a contingency line of 10 to 20 percent, as a guideline, based on what will be opened up.
  5. Send the same scope and questions to three contractors and compare quotes line by line.

The AI total you started with should be gone by the end. What remains is a priced list you can defend line by line. If the project also involves new furniture, our ChatGPT room design prompts include one for splitting a furnishing budget.

Frequently asked questions

Can ChatGPT estimate the cost of a bathroom remodel?

ChatGPT can turn a bathroom scope into line items with quantities and do the arithmetic, but it does not know current local prices or labour rates. Use it to build the structure of the budget, then fill in prices from retailer listings, published cost guides and contractor quotes, with the date you checked each one.

How accurate are AI renovation cost estimates?

A total from a chatbot is not reliable on its own, because prices come from training data or a web search and may be stale, national, or invented. The structure is the reliable part: the line items, quantities and forgotten costs. Accuracy comes from replacing every price with a sourced figure and testing the total against itemised quotes.

How much contingency should I add to a renovation budget?

A common guideline is 10 to 20 percent of the priced work. HUD's older 203(k) rehabilitation handbook required at least 10 percent on older houses and allowed up to 20 percent for major remodelling. Use the higher end for older homes and for work that opens walls or floors.

What does the Cost vs Value report measure?

The Cost vs Value Report from the Journal of Light Construction compares the average cost of 28 defined remodelling projects with the value they retain at resale, nationally and across 119 US markets. In the 2025 report the midrange bath remodel, a full fixture replacement in a 5 x 7 ft bathroom, had a national average job cost of $26,138.

Is it safe to upload a contractor quote to ChatGPT or Gemini?

Remove names, addresses, phone numbers, signatures and account details first. Google says human reviewers read some Gemini chats and asks users not to enter confidential information, and ChatGPT lets you turn off model training in its data controls. The line items and prices are what the chatbot needs, not the personal details.

Can AI tell me what is behind my bathroom walls?

No. Rot, old wiring, water damage or a damaged subfloor only show once something is opened or inspected. That is why a renovation budget carries a contingency, and why you should agree with the contractor in writing how problems found after demolition will be priced.
